Reference

Open in Claude.md

Pipeline configuration

Fields, defaults, command behavior, and limitations of .radial/pipeline.json.

.radial/pipeline.json declares the stages and gate names used to record a build. Keep it in version control. Run build commands from the repository root: the CLI reads the file relative to the current working directory.

  1. pipeline.jsonDeclareStage ids, positions, gate ids, tiers
  2. Agent + CLIExecuteStart stages and run named checks
  3. Issue buildRecordAttempts, results, evidence, sessions
The agent or script invokes each step. The JSON does not schedule work or approve transitions.

For a complete example with a failing check and a retry, follow Implement a workflow with Radial.

Initialize and inspect

bash
radial build pipeline init
radial build pipeline show
radial build pipeline show --json

init writes the shipped configuration only when the file does not exist. It leaves an existing file unchanged. show displays the effective configuration, its source (shipped or repo), and its SHA-256 hash. With --json, the result is an object whose pipeline property contains the resolved configuration.

Neither command opens a build or runs a check.

Default configuration

When the file is absent, the CLI uses:

json
{
  "version": 1,
  "stages": [
    { "id": "plan", "position": 0 },
    { "id": "prototype", "position": 1, "optional": true },
    { "id": "materialize", "position": 2 },
    { "id": "build", "position": 3 },
    { "id": "verify", "position": 4 }
  ],
  "gates": [
    { "id": "validate", "tiers": ["T0", "T1", "T2", "T3"] },
    { "id": "unit", "tiers": ["T1", "T2", "T3"] },
    { "id": "e2e", "tiers": ["T2", "T3"] },
    { "id": "review", "tiers": ["T1", "T2", "T3"] },
    { "id": "browse", "tiers": ["T1", "T2", "T3"] }
  ]
}

Fields

FieldShapeBehavior
versionNumber; use 1Defaults to the shipped version when omitted. Included in the configuration hash; it does not select a different execution engine.
stagesArray of stage objectsReplaces the entire shipped stage list when supplied. Defaults to the shipped list when omitted.
gatesArray of gate objectsReplaces the entire shipped gate list when supplied. Defaults to the shipped list when omitted.

Stage objects

FieldShapeBehavior
idStringIdentifier passed to radial build stage. Use stable, unique ids.
positionNumberDefault recorded position when the stage starts. Use distinct nonnegative integers. This is display order, not a prerequisite rule.
optionalBoolean; defaults to false in the hashDeclares optionality. The CLI does not use this field to enforce whether a stage must run.

Adding a custom stage does not create or invoke a skill. Your agent or script must explicitly start and complete it. The CLI accepts undeclared stage ids, too; a missing position defaults to the number of configured stages. The --position flag overrides the configured position for a stage start.

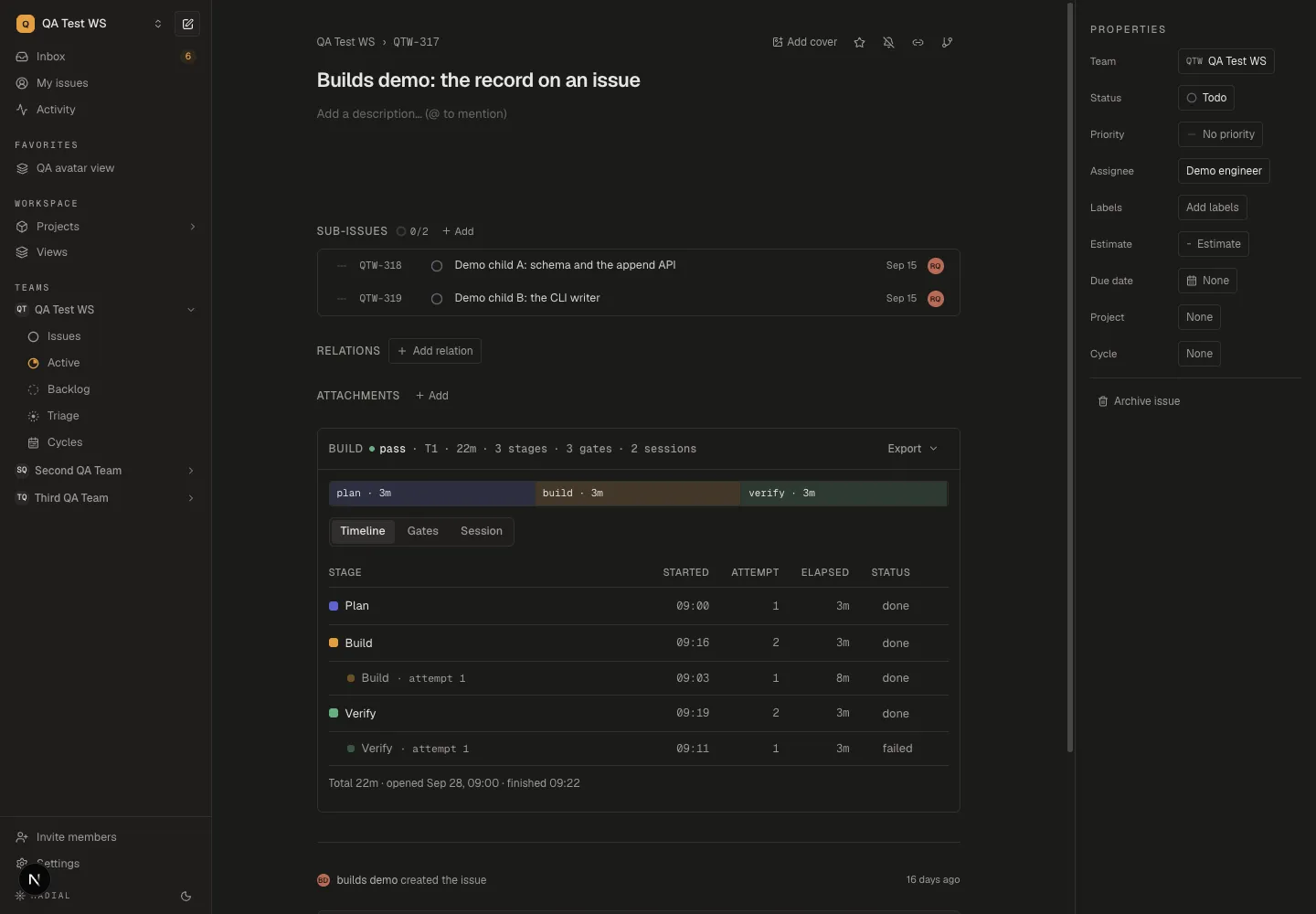

Radial issue page with the Timeline ordering plan, build, and verify, and earlier attempts retained beneath the latest attempt.
Stage positions control the order under Build → Timeline on an issue. Earlier attempts remain visible. App screenshot with sample data. View full size.

Gate objects

FieldShapeBehavior
idStringIdentifier passed to radial build gate --gate. The CLI rejects ids outside the effective gate list.
tiersArray of stringsDeclares applicability. Omitted or empty means no tier restriction in the configuration helper.

The defaults use T0 through T3 as tier labels. The pipeline does not compute a risk tier, select commands, or check whether a reported exclusion is valid. Your runner supplies that policy. Declaring tiers alone never skips or runs a gate.

The loader is not a strict schema validator. Use the shapes above: malformed JSON fails to load, while some unsupported shapes fall back to defaults or fail later. Duplicate ids and invalid positions are not comprehensively rejected. Unknown properties do not add execution behavior.

Replacement and empty lists

Lists replace defaults wholesale. To change one gate, include every gate you want to retain. Setting only gates keeps the shipped stages; setting only stages keeps the shipped gates.

An empty list is an explicit replacement. gates: [] leaves the CLI with no valid gate ids. Do not use it as a security policy: the server treats an empty or absent snapshot gate list as having no gate allow-list.

The walkthrough uses this smaller definition:

json
{
  "version": 1,
  "stages": [
    { "id": "plan", "position": 0 },
    { "id": "build", "position": 1 },
    { "id": "verify", "position": 2 }
  ],
  "gates": [
    { "id": "unit", "tiers": ["T0", "T1", "T2", "T3"] }
  ]
}

Connect gate names to commands

The configuration has no command field. Supply a command when recording a gate:

bash
radial build gate --gate unit --exec -- node --test src/release-note.test.mjs

This example uses the test file from the walkthrough and requires an open build or draft. The CLI runs the command after --, stores its output in the journal, and records the exit code, duration, and an extracted summary. Exit zero produces pass; a nonzero exit produces failed and a nonzero CLI exit. Inspect the output to confirm that the intended checks ran.

To record an exclusion your runner has already determined:

bash
radial build gate na --gate e2e --tier T1

That command requires a configuration declaring e2e, such as the default above. It records an n/a row naming T1; it does not verify that T1 excludes the gate. Results supplied with --result are agent-reported evidence. See Build records for provenance.

With the agent skills, rd-verify resolves commands from a wrapper, repository instructions, or package scripts. Keep those command names aligned with the gate ids recorded by rd-build.

Complete a stage

The built-in ids have these payload requirements when completing a stage with status done:

StageRequired payload field
planbaseline
prototypeattachment
materializeissues
buildNone
verifyoutcome, one of pass, partial, or failed
bash
radial build stage done verify --payload '{"outcome":"pass"}'

These required fields follow the built-in id even if you change its position. Custom ids have no built-in required payload fields. --payload-file reads JSON from a file when the payload is too large for an inline argument.

A skipped stage requires a reason:

bash
radial build stage done prototype --status skipped --reason "No interface change"

The CLI requires that reason regardless of the stage's optional value. Neither a completion payload nor radial build finish proves that all required checks passed.

Snapshots and changes during a build

The CLI hashes the resolved version, stages, and gates. Object key order, gate order, and tier order do not affect the hash. Stage positions do affect it. source and the hash itself are excluded.

The server snapshots the pipeline when it first creates the issue's build. Resuming or reopening that build preserves the snapshot, which the server uses to validate gate ids. A draft binds using the configuration in effect at bind time, so keep its file stable while recording it.

The CLI reads the current local file for subsequent commands. If you change gate ids mid-build, local validation and the server snapshot can disagree. Keep the definition unchanged for an existing build; reopening the same issue's build does not adopt a new snapshot. Apply a revised definition to a new build on a different issue.

Troubleshooting

SymptomCheck
show reports shipped after editing the fileRun from the directory containing .radial/pipeline.json; the CLI does not search parent directories.
Could not read ...pipeline.jsonCheck JSON syntax and the field shapes above.
unknown gate in the CLICompare the id with pipeline show; a supplied list replaces all defaults.
A gate is accepted locally but rejected during syncCompare the local definition with the pipeline stored on the existing build.
A new stage never runsAdd an explicit stage invocation to your agent's procedure or script.
A build finishes with missing or failed gatesFinishing records the end of execution. Your automation must evaluate readiness separately.

For decisions about evidence freshness and approval enforcement, use the workflow design guide.
